Tag: Cost & Schedule Review
-
Update of project status
The HL-LHC project has continued to make impressive progress since the annual meeting in Genoa at the end of 2024. In particular I would like to highlight here the celebrations for the first Beam Screen being completed at CERN, the successful repair of the prototype RFD Crab Cavity cryo-module and its on-time installation in the…
-
Planning of the 2024 Annual Meeting and Cost & Schedule Review
Our annual HiLumi Cost & Schedule Review (CSR) will take place between the 11th and 14th November. After another lively procurement year, where commitments are expected to reach 74% of the budget at completion by the end of the year, we need to consolidate the status of the full project for what might be the…
-

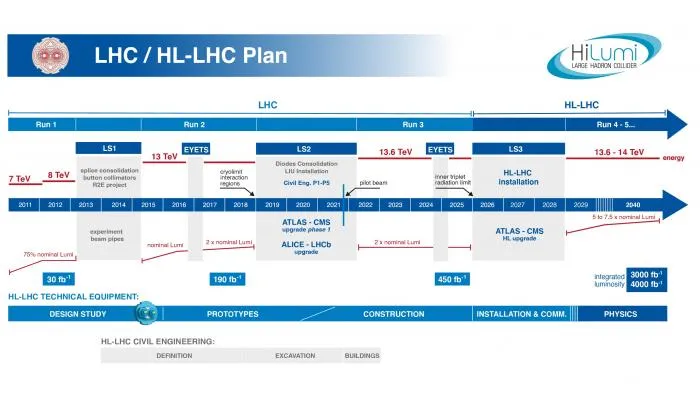

Long Shutdown 3 schedule and readiness review
The HL-LHC Project will culminate with the accomplishment of a very demanding installation phase during the Long Shutdown 3 (LS3). To assess the project’s readiness, a tracking process on the expected availability of equipment has been implemented. The careful follow-up of this installation schedule float plays an important role in the strategical decision-making process. It…
-
Update on the HL-LHC Project Status
The project has reached several key milestones since the last newsletter. Among the many achievements, I would like to highlight here the celebrations for the successful validation of the CERN MQXFB quadrupole improvement plan and the successful validation of the first two magnets destined for direct installation in the tunnel (MQXFB03 and MQXFB04), the delivery…
-
Update on the HL-LHC Project Status
The project reached several key milestones since the last Newsletter. Among the many achievements I would like to highlight here the celebration for the completion of all Civil Engineering work in January at CERN. The new underground structures have been completed by the end of 2022 and the new surface buildings at P1 and P5…
-
Planning of the CSR’23
The now annual Cost & Schedule review 2023 will take place between the 13th and the 17th of November. As requested by the ATS management, this will be an extended edition, alternating with the ‘light’ version held in 2022. This year, most work-packages will be asked to present their budget, schedule, and changes therein, as…
-
Planning of annual meeting and CSR’22, including summary of CSR’21 outcome
Following a very successful exercise in 2021, CERNs Council has requested the Cost & schedule reviews of the HL-LHC project to be held annually, a lighter edition alternating every second year with a full project review. The 2022 – a light – edition has been scheduled for the 14th – 15th November. The CSR’21, first…
-
Update on the HL-LHC Project Status – Issue 6
Progress since the last collaboration meeting in October 2021 has been impressive and the project passed several key milestones for the project implementation despite the turbulences caused by COVID-19 and the crisis in Ukraine. Among the many achievements, I would like to highlight here the successful endurance test validation of the MQXFA05 triplet quadrupole magnet…
-
Preparation of the C&S Review 2021
At the request of the management of CERN, four extensive Cost and Schedule Reviews (CSR) of both the LIU and the HL-LHC projects were carried out in March 2015, October 2016, March 2018, and November 2019. An international panel of experts, headed by the CERN Machine Advisory Committee chairman and composed by the CMAC members…
-
Update on the HL-LHC Project Status – Issue 5
The progress since the last collaboration meeting in October 2020 has been truly remarkable and the project successfully passed several key milestones for the project implementation in spite of the COVID-19 restrictions. Among the many achievements, I would like to highlight here the successful validation of two pre-series MQXFA triplet quadrupole magnets by our US…
